MEDIA RELEASE: UPDATE: EMERGENCY MUNICIPAL LOADSHEDDING RELIEF GRANT

Date: May 10, 2024

Funds received from the Western Cape Provincial Government in terms of the Emergency Municipal Loadshedding Relief Grant, have been applied to procure standby generators for critical water pumpstations in the greater Mossel Bay area.

The approved scope of work for this project includes the purchase and installation of back-up generators for water and wastewater infrastructure as an immediate response to prolonged loadshedding. The project has a its purpose mitigating the impact of loadshedding on the provision of basic services and potential health risks.

The procured or installed assets include the following locations:

  • Grunter pumpstation (Extension 23, Mossel Bay)
  • Omega pumpstation (De Bakke – Extension 11, Mossel Bay)
  • Krieketveld pumpstation (Great Brak River)

Equipment ordered and delivered are as follows:

  • Grunter pumpstation – 65kVA standby generator
  • Omega pumpstation – 500kVA standby generator
  • Krieketveld pumpstation – 150kVA standby generator

Concrete plinths have been completed for the 3 sites where generators will be installed.

The tender for the supply of standby generators was awarded to Messrs MDL Engineering Company of George on 3 May 2023. Orders for the 650kVA and 500kVA units were placed on 8 and 29 May. The units were delivered to Mossel Bay on 21 August 2023. Defects were however noticed which had to be repaired at the manufacturer’s facility. The units were therefore removed for repairs on 5 October 2023. The repairs have been completed and the units were returned to Mossel Bay on 11 March 2024.

The tender for the construction of the concrete plinths was awarded to Messrs. 3rd Generation Trading. Plinths were completed on 31 January 2024.

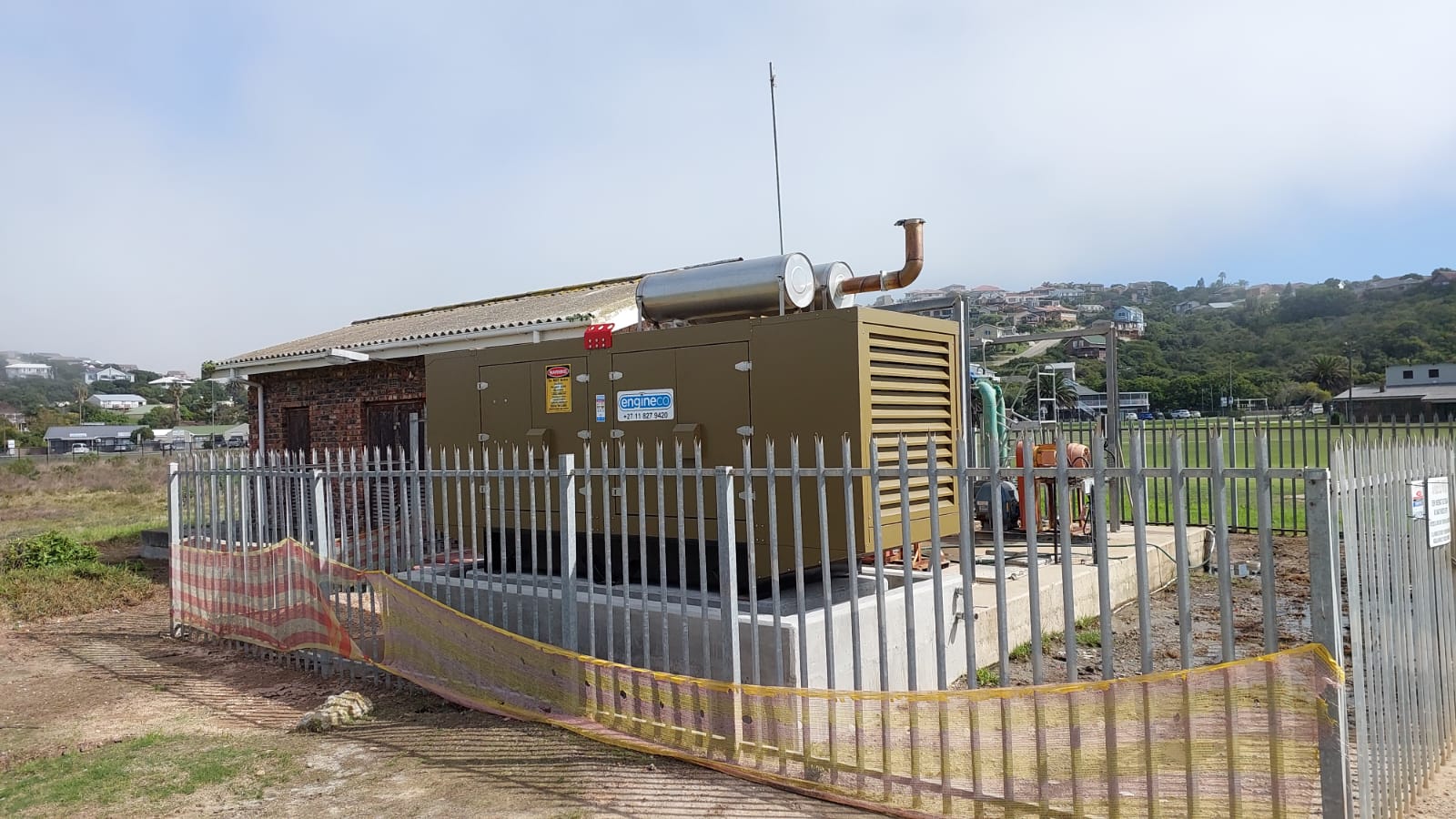

The 150kVA generator at Krieketveld Pumpstation in Great Brak River has been installed on site. The two larger units require low voltage cables to connect, which has been ordered as it is not a municipal stock item. Delivery is awaited.

The expenditure to date is as follows:

  • Grant funding: R 4 849 960.86
  • Co-funding (CRR): R 80 724.04
  • Total, including VAT: R 4 930 684.90
